Communication Links Survey - Port Victoria Wind Farm, Seychelles
+44 1787 319001

Port Victoria Wind Farm, Seychelles

Introduction

During the planning stages of an 8 turbine wind farm in the Republic of Seychelles, concerns were raised by the Public Utilities Corporation (PUC) over the potential for the wind turbines to interfere with their wireless microwave links.

In order to address these concerns the wind farm developer, Masdar Power, commissioned Pager Power to investigate the PUC’s concerns by undertaking technical analysis and a communications survey.

Pager Power’s results assisted in resolving the PUC’s concerns providing information to optimise the wind farm layout to minimise the effects on the microwave links and avoid planning delays.

The project is now constructed and operational as of June 2013. Three of the 8 wind turbines can be seen in the image below.

Background

The 8 turbine development, hereafter referred to as the Port Victoria Wind Farm, was to be the first large-scale renewable energy project in the Republic of Seychelles.

The 750kW turbines were to be distributed on two small islands off the coast of Mahé. However, during the planning process the PUC raised concerns about potential interference to wireless microwave communication links in the area.

Needing to know more about these concerns the wind farm developer, Masdar Power commissioned Pager Power Ltd to carry out a Desk Based Communication Links Report, which was then followed up by a Communication Links Survey.

The Challenge

There were three prominent challenges associated with this project:

  1. Although we had undertaken work in many countries this was our first project in Seychelles.
  2. There was limited mapping and other available information for Seychelles.
  3. The survey of the microwave link ends was in remote and non-accessible locations. Some of the link ends were sited amongst thick vegetation, making them challenging to access as can be seen in the image below.

The Process

In the first instance we identified which effects could have been caused by the proposed wind turbines. We used the provided link end coordinates along with the wind turbine layout to create a 2 dimensional (2D) exclusion zone chart (figure 4 below).

The exclusion zone chart highlighted which of the planned turbines could have affected the microwave links. Due to the distances from the microwave antennae, diffraction effects on the link paths appear to be the main potential effect.

The next step was to undertake 2D clearance calculations for the specific links and turbines where interference could occur. An example for Wind Turbine 1 (WT1) is shown in figure 5 below.

However, due to potential interference that was identified it was decided to undertake 3 dimensional (3D) clearance calculations.

Since the antennae heights of the microwave link ends were not available and coordinate information required confirmation, a microwave link survey was decided to be undertaken in order to:

  • Obtain the height of the antennae;
  • Confirm the existence of the microwave link ends; and
  • Confirm the coordinates of the microwave link ends.

Following the completion of the link survey, the 2D exclusion zone calculations were then repeated based on the new coordinate data and 3D analysis was undertaken.

The Solution

Using the 2D modelling, the survey results and the 3D modelling, we were able to conclude that all planned wind turbines were unlikely to affect the microwave links.

Furthermore, micrositing modelling was undertaken, for locations within 100m of the planned turbine locations in all directions, in order to identify suitable locations for turbine micrositing (figure 6).

The Result

The Pager Power results were accepted by the PUC and the wind farm was given the go ahead.

The 8 turbines went on to be constructed and the Port Victoria wind farm became operational in June 2013.

The PUC has now taken over ownership of the project and during the first year of operation, it was reported that the wind farm was producing enough electricity to supply the intended 2,200 homes.

References

[1] Image accreditation: “Ste Annes Island” by David Stanley / CC BY 2.0 / Image resized and shape altered.

Figure 1: Three of the eight operational wind turbines in the Republic of Seychelles[1]

Figure 2: Wireless microwave link dishes which could have been affected by the planned turbines

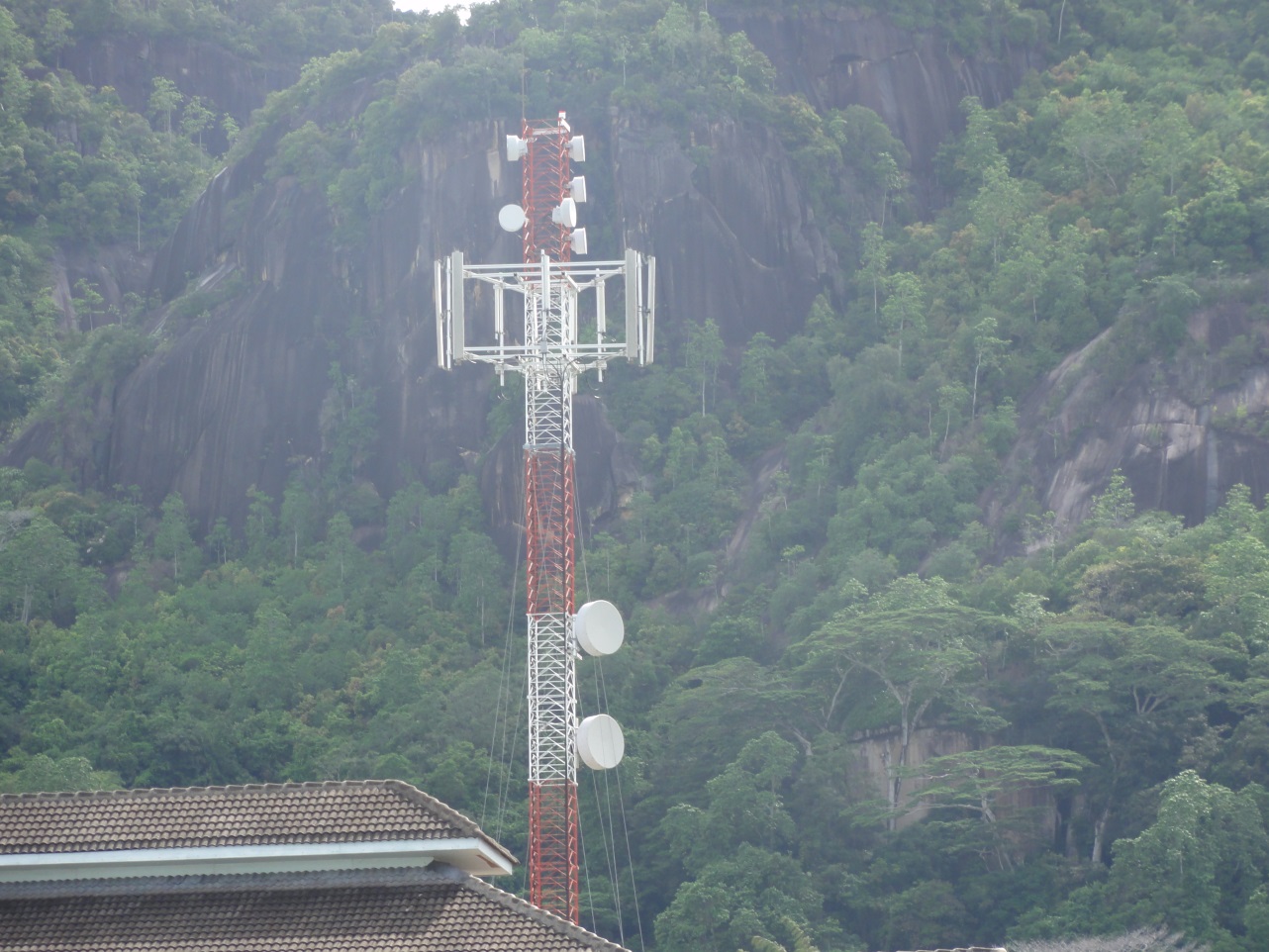

Figure 3: Wireless microwave link in a remote location

Figure 4: 2D Microwave link chart

Figure 5: Example wind turbine – microwave link clearance calculation

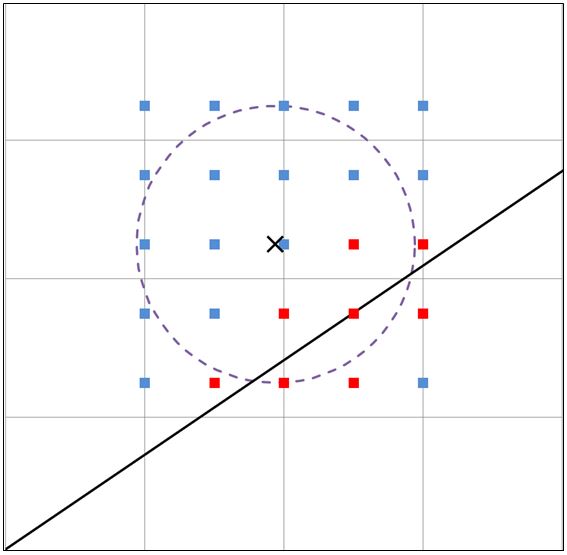

Figure 6: Example wind turbine – microwave link clearance calculation for micrositing

    LATEST TWEETS

    Today is #EarthDay! 🌎
    For the 54th edition of Earth Day, the organisation has announced its commitment towards a 60% reduction in fossil-fuel plastic production by 2040, with the 2024 theme, #PlanetvsPlastics .  Learn more:
    #earthday2024

    The UK government is set to review glare impacts from car headlamps. We consider what this means and look at how glare impacts are handled in a wider context from various sources. Learn more: https://www.pagerpower.com/news/uk-government-to-review-headlamp-glare/
    #aviationsafety #driversafety

    This month in our Back to Basics series, we uncover the ways in which energy generated by wind and solar farms can be stored and how this technology will shape the future of our energy systems. Learn more: https://www.pagerpower.com/news/back-to-basics-part-4-energy-storage/
    #energystorage

    Load More...
    Make an Enquiry

    You can make an enquiry here

      Your Name (required)Your Email (required)Subject Your Message
